ANAVA SAMUI | Latest Project Progress (October 15, 2026)
Refined craftsmanship, steady advancement. ANAVA SAMUI continues to uphold uncompromising quality and engineering rigor across every facet of development. Interior finishes and exterior facade assemblies are advancing rapidly—bringing sleek glass balustrades and balcony sliding doors into place—while foundation and secondary structural works mark major new milestones across the site.
Heartfelt thanks to all our valued owners and partners for your ongoing confidence and trust! As of October 15, 2026, the site construction milestones are as follows:
Project Progress as of October 15, 2026:

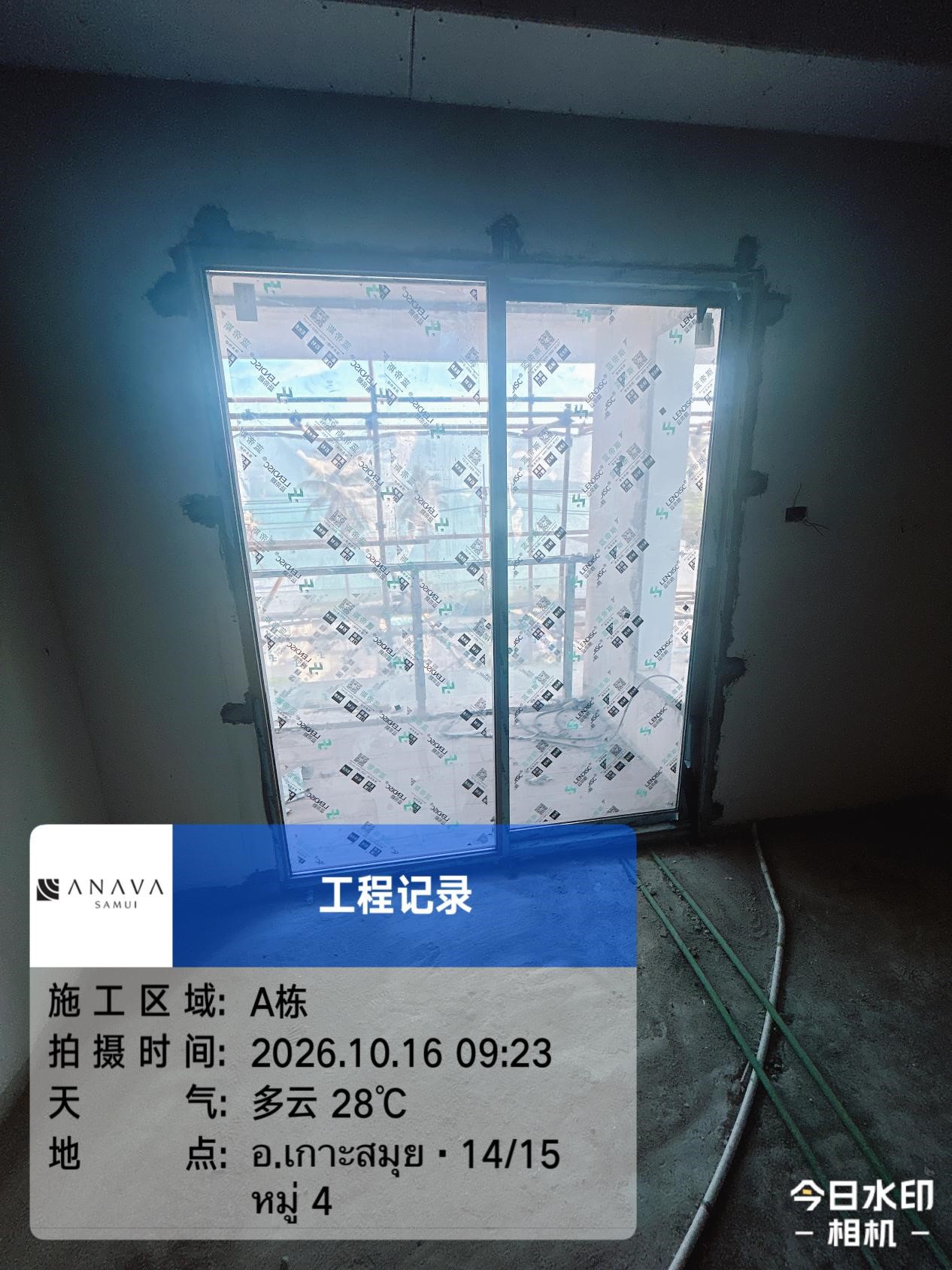

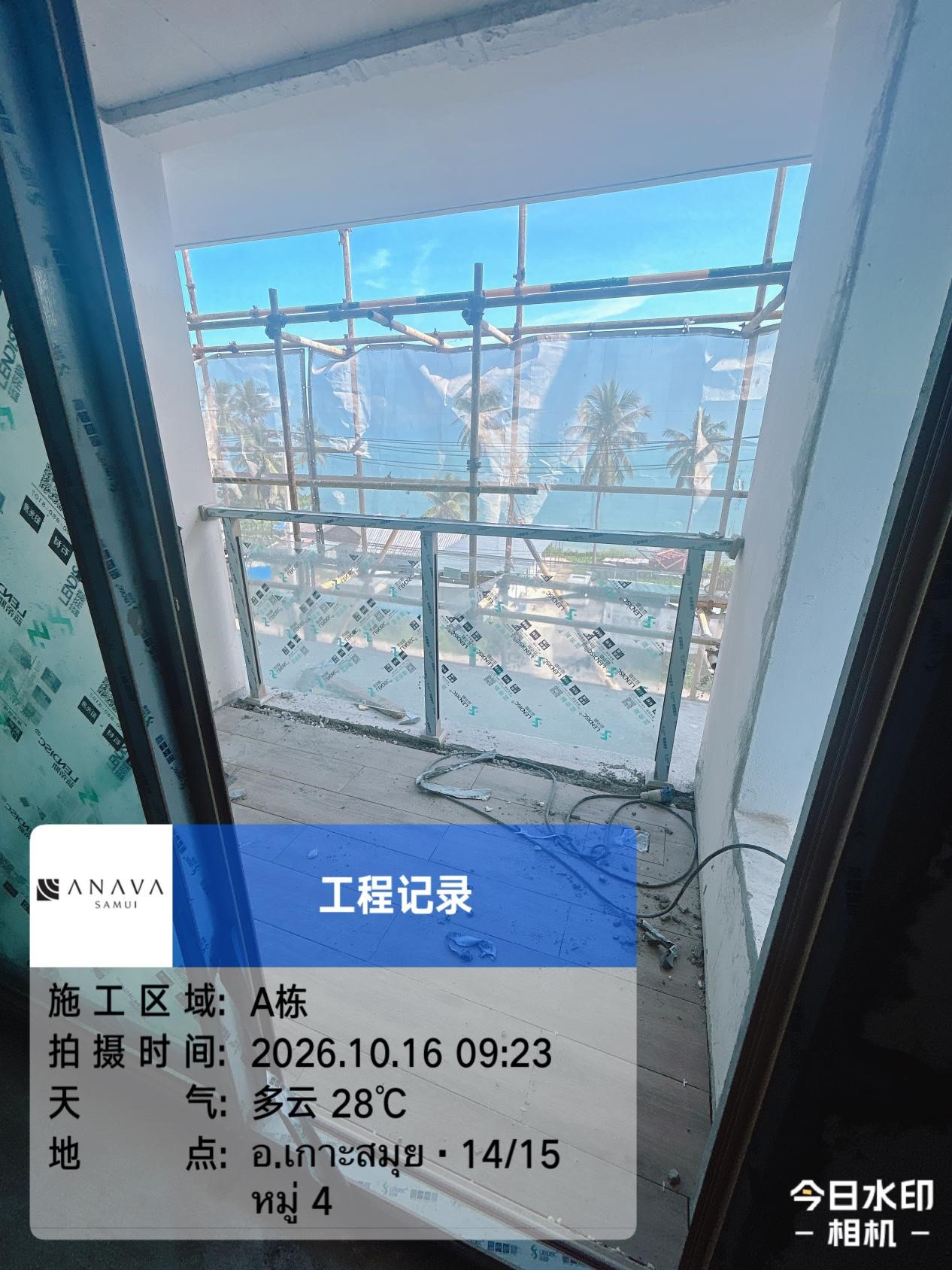

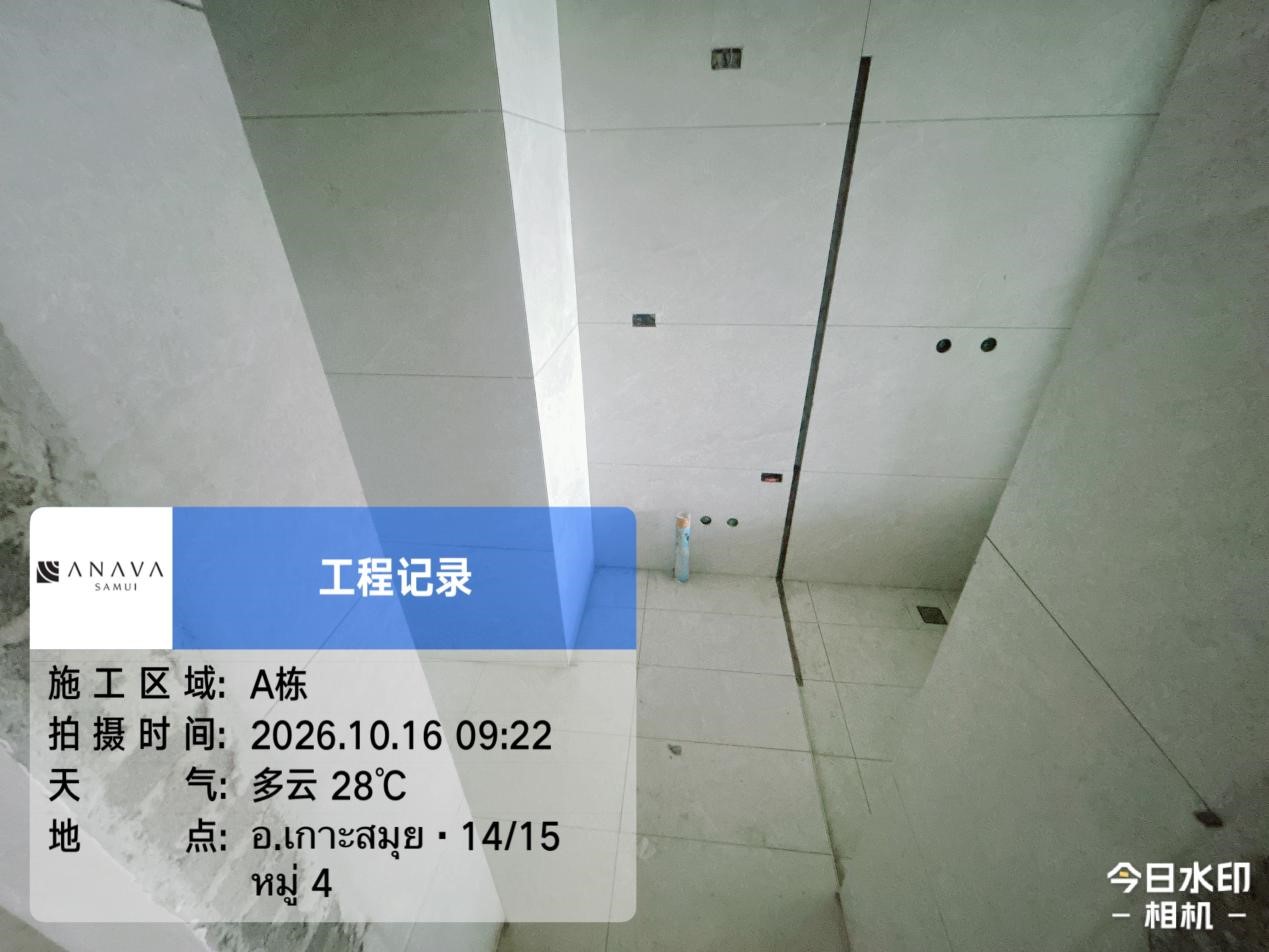

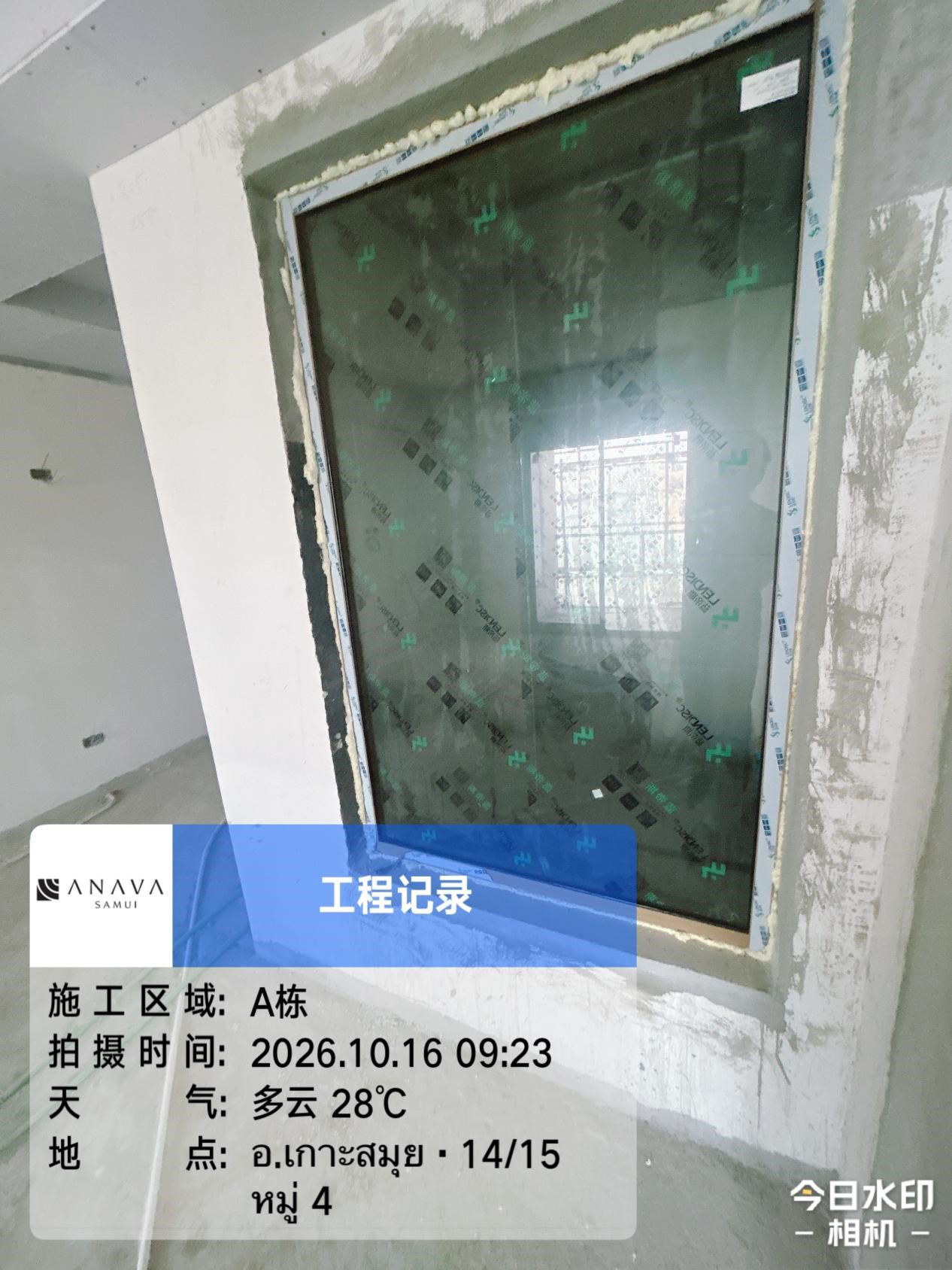

Building A: Bathroom floor tiling, bathroom glass installation, balcony floor tiling, balcony glass balustrade installation, and balcony aluminum sliding door installation 90% completed.

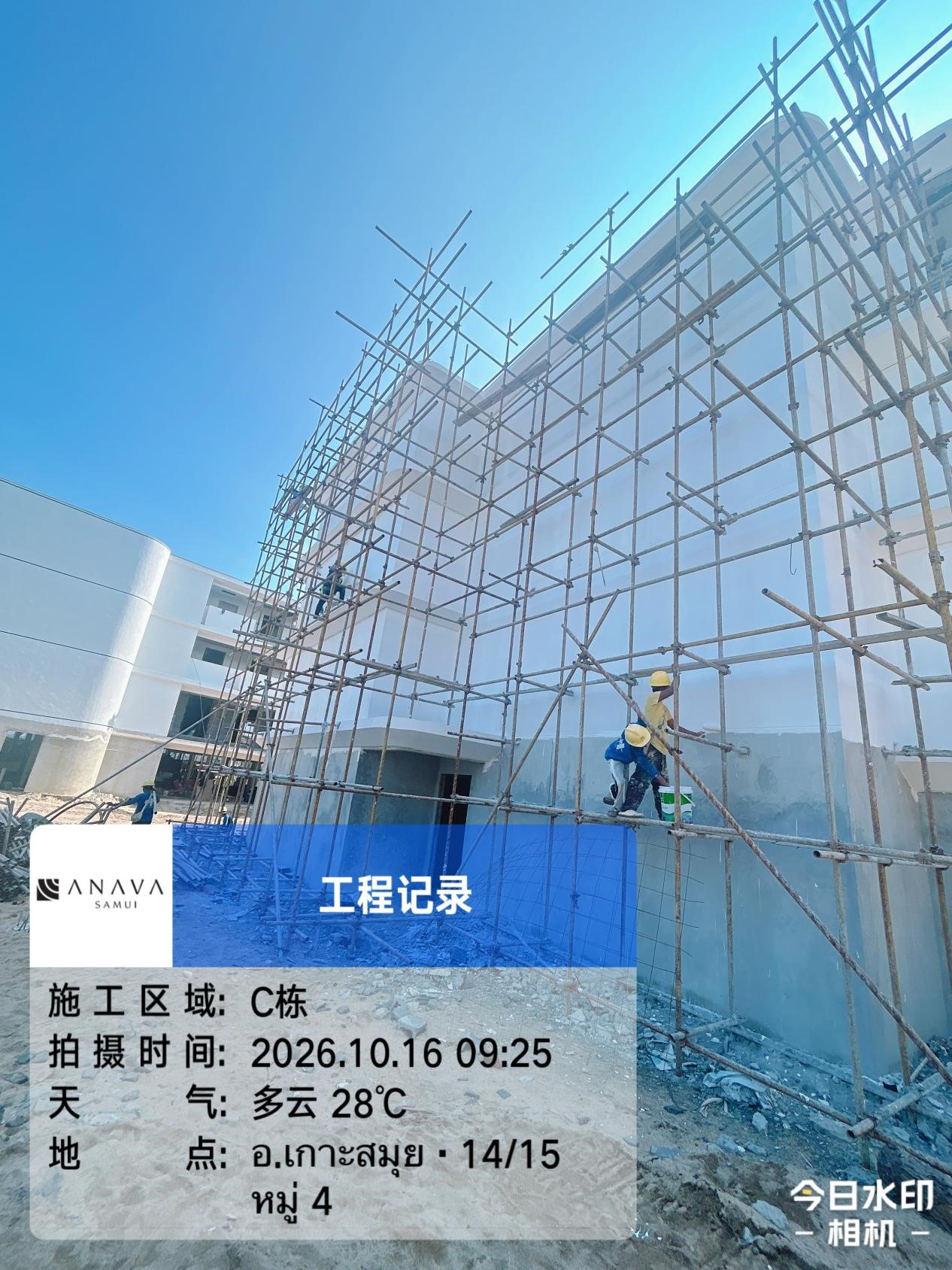

Building C: Public area ceiling grid installation 100% completed; exterior wall paint finishing 50% completed.

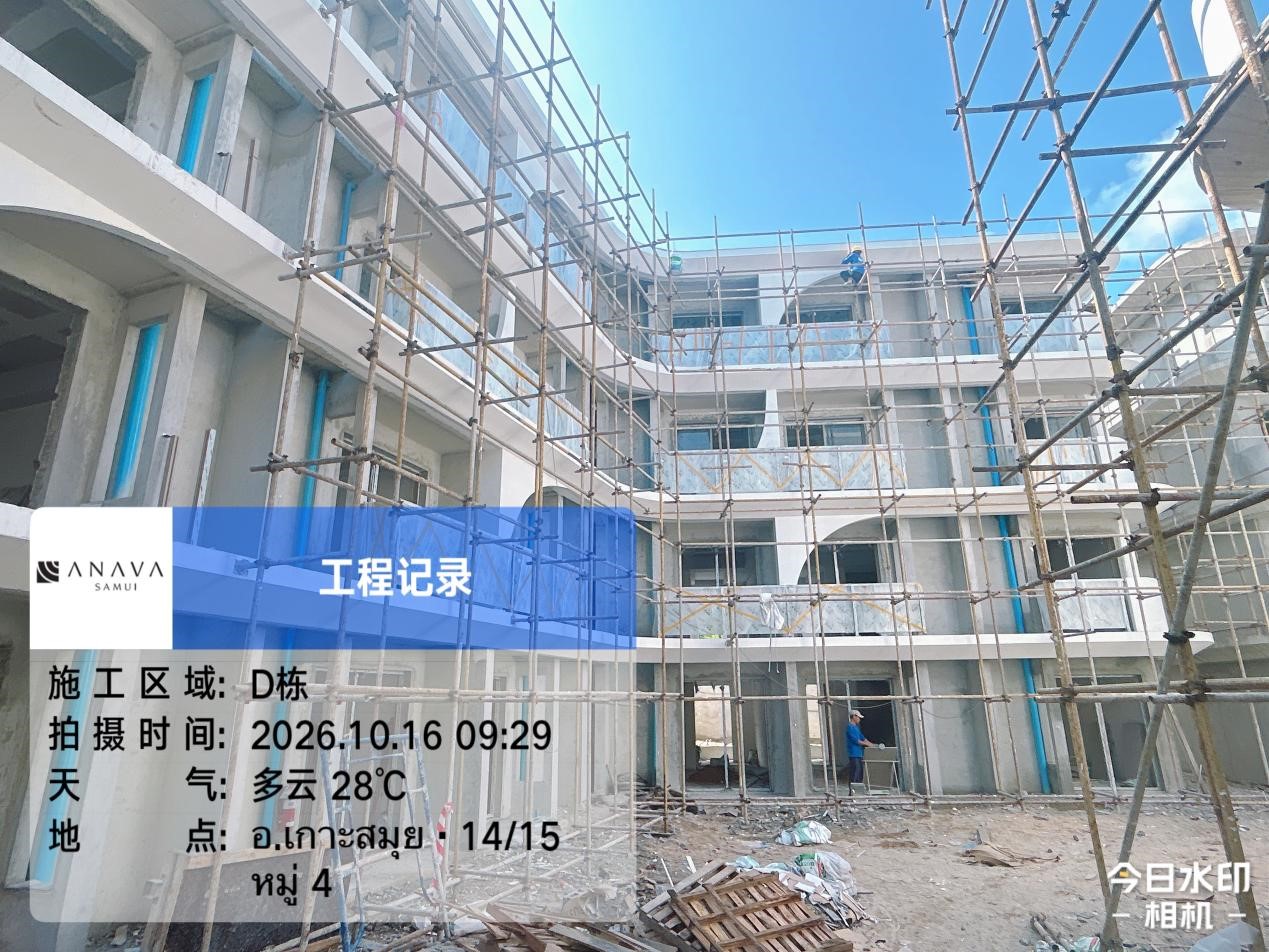

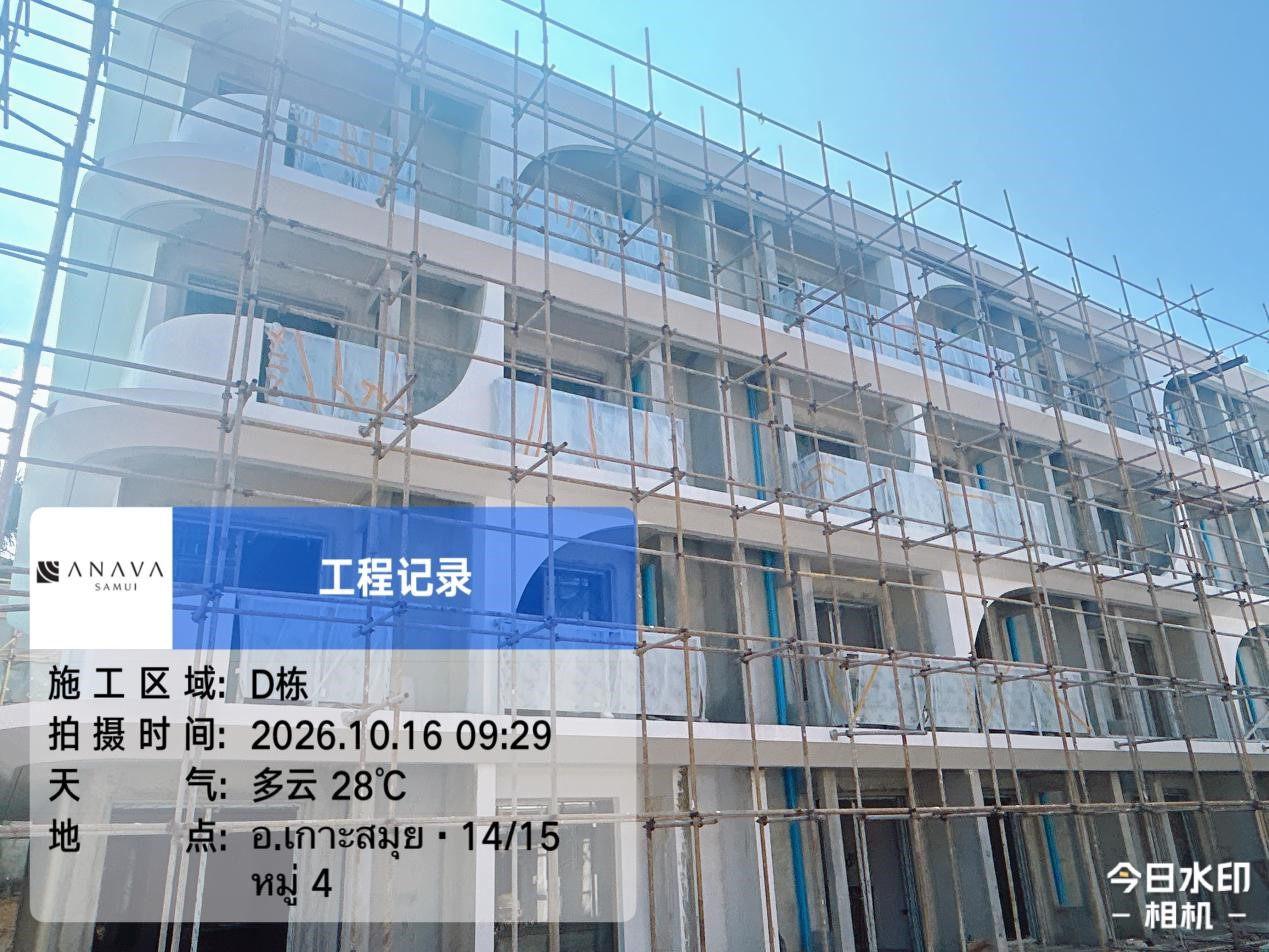

Building D: Balcony glass balustrade installation 90% completed; balcony aluminum sliding door installation 60% completed.
Building E: Exterior wall paint finishing 100% completed; balcony glass balustrade installation 15% completed.
Building F: Balcony glass balustrade installation 90% completed; balcony aluminum sliding door installation 40% completed.
Building H: Interior wall plastering 100% completed.
Building M: Main structural work 100% completed; secondary structural work 15% completed.

Building N: Structural foundation works 100% completed.
